How to Set a Construction Project Contingency Budget

A larger reserve isn’t automatically a safer one: a construction project contingency budget should reflect the design’s maturity and the risks still outstanding. For a UK new build with a settled design, a typical allowance is 5% to 10% of construction cost; a refurbishment or conversion commonly calls for 10% to 15%, while an older building with structural uncertainty may need up to 25%.

Choosing a percentage is only the starting point. It’s understandable to want a clear buffer for unexpected costs, but contingency works best when it’s linked to specific risks and reviewed as the project develops, not treated as spare money.

This guide explains how to choose an appropriate allowance, what it should cover and which costs belong elsewhere. It also shows how surveys and design development can clarify risks, and how project controls track drawdowns, pending requests and remaining funds to keep the budget visible throughout construction.

Key Takeaways

  • Set the allowance against the project’s design maturity, site conditions and outstanding risks, rather than choosing a percentage by habit.
  • Keep contingency for unforeseen risks; separate it from planned items whose final costs are still being worked out.
  • Use surveys, ground investigations and design development to uncover uncertainty early and refine the reserve as risks change.
  • Review remaining contingency against current risks and forecast costs throughout delivery, not simply because time has passed.
  • Record each drawdown, pending request and release so the team can see what remains and why funds have been used.

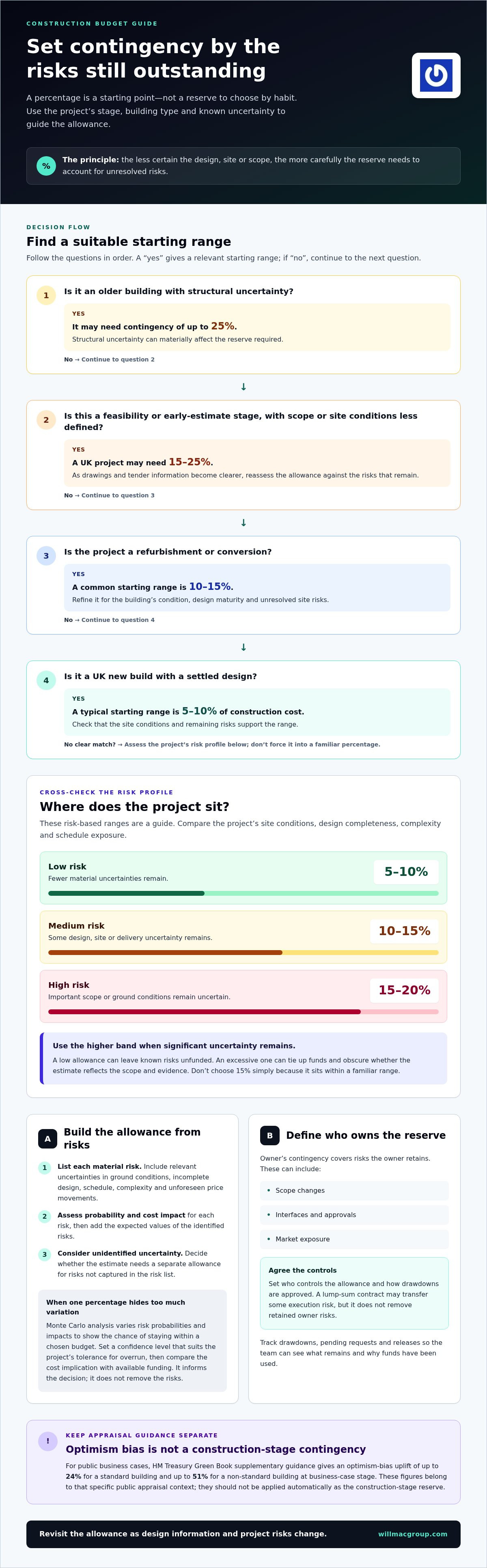

How do I choose the right contingency percent for my project?

Choose a percentage by assessing design maturity, site uncertainty and the risks that remain, not by treating every build alike. For an early estimate, 5-15% can be a rule of thumb; the risk profile should determine where your project sits within that range.

An allowance that’s too low can leave known risks unfunded and put pressure on the project budget if they occur. One that’s too high can tie up funds unnecessarily and obscure whether the estimate reflects the project scope and available evidence.

  1. Apply risk-based contingency percentages

    Classify the project’s risks before selecting a percentage. A low-risk construction project may use 5-10%, a medium-risk project 10-15%, and a high-risk project 15-20%. Compare site conditions, design completeness, complexity and schedule exposure; use the higher band when important scope or ground conditions remain uncertain. Don’t choose 15% simply because it appears within a familiar range.

  2. Calculate contingency from risk analysis

    List each material risk, estimate its probability and assess its cost impact. Add the expected values of identified risks, then consider whether the estimate also needs a separate allowance for uncertainty that risk identification hasn’t captured.

  3. Use quantitative risk analysis when a single percentage hides too much variation. A Monte Carlo analysis models possible outcomes by varying risk probabilities and impacts, then shows the chance of staying within a chosen budget. Set a confidence level that suits the project’s tolerance for overrun and compare its cost implication with available funding. The result informs a decision; it doesn’t remove the underlying risks.
  4. Review owner’s contingency and percentage risks

    Define the owner’s contingency for risks the owner retains, such as scope changes, interfaces, approvals or market exposure. A lump-sum contract may transfer some execution risk, but it doesn’t remove those retained risks. Agree who controls the allowance and how drawdowns are approved. A low reserve can force difficult funding decisions; an excessive one may leave funds unused or conceal an immature estimate.

  5. For public business cases, distinguish optimism bias from a project contingency percentage. According to HM Treasury, Green Book supplementary guidance gives public bodies an optimism-bias uplift of up to 24% for a standard building at business-case stage, and up to 51% for a non-standard building at business-case stage. These uplifts reflect a specific public appraisal context, so don’t apply them automatically as the construction-stage reserve.

What costs should contingency cover (and not cover)?

Separate contingency from planned costs in your estimate, then set a reserve for risks whose timing or scale remains uncertain. Project type, design stage, site information and the treatment of price changes all affect what belongs in the reserve.

For inflation, price changes and VAT, show forecast escalation and VAT treatment clearly in the estimate rather than hiding them in contingency. Keep the budget consistently VAT-inclusive or VAT-exclusive, based on the project’s VAT treatment, and reserve contingency for unforeseen cost movements or other identified risks.

  1. Set allowances by project type and stage

    Choose a starting range that reflects the work and the estimate’s maturity. A UK new build with a settled design commonly uses 5-10% contingency, while a refurbishment or conversion commonly uses 10-15%. An older building with structural uncertainty may need up to 25%. At feasibility or early-estimate stage, a UK project may need 15-25%, as scope and site conditions are less defined.

    As drawings and tender information become clearer, reassess the allowance against the risks that remain. Public works projects are commonly allocated 5-10%; don’t apply that range mechanically to a complex refurbishment or use an early-stage reserve after uncertainty has reduced.

  2. Identify factors affecting allowances

    List factors that could change costs, such as difficult ground conditions, incomplete design information, schedule uncertainty, and material or labour price movements that could not have been foreseen at tender. Link each identified risk to its possible effect on the estimate. This makes contingency a planned reserve for uncertainty, not spare money for routine costs.

    Use contingency for unforeseen conditions or omissions that emerge during construction, not regular project costs or minor scope adjustments. A delay, for example, may affect indirect costs and contractor commitments, so assess schedule exposure alongside physical site risks.

  3. Distinguish contingency from allowances

    Separate uncertain risks from planned items with costs still to be finalised. Under RICS New Rules of Measurement (NRM1), contingency is a risk allowance added to the base cost estimate for items that cannot be precisely predicted. An allowance, by contrast, sets aside budget for a known item whose final cost remains variable.

    Record each allowance against its item and state whether it covers materials, installation labour or both. For example, an unfinished selection may need an allowance; an unidentified site condition belongs in the risk register and may justify contingency. This distinction helps prevent mistakes and improves confidence in the estimate.

  4. Treat inflation, price changes and VAT

    Show anticipated inflation or price escalation as a forecast cost in the estimate, with its timing and basis visible. Use contingency for unexpected price movements that could not reasonably be anticipated at tender, not as a substitute for planned escalation. Review material and labour exposure against procurement timing and the project programme.

    For VAT, keep the cost plan consistent and show whether figures include or exclude it, reflecting the project’s VAT treatment. Don’t count recoverable VAT as a project cost or omit VAT that the budget must fund. Clear separation makes the reserve easier to assess. For a defined construction project scope, this distinction supports more useful cost planning.

Reducing contingency through surveys and design development

A UK project team can reduce contingency by investigating site conditions, developing the design and updating its risk assessment. Remove or revise allowances only when evidence shows that the related uncertainty has reduced or passed.

  1. Commission surveys and ground investigations early. Use site information to replace unknowns with findings that can inform the design and estimate. For example, ground investigations can clarify whether anticipated ground risks remain relevant. Record each finding in the project risk register, then adjust the expected exposure and remaining contingency. Don’t release reserve simply because a survey is complete; base the change on what it reveals.
  2. Develop the design in stages. A project that is only 10% designed may need a contingency of 25% to 40%, reflecting substantial uncertainty. As decisions, drawings and specifications become clearer, revisit the allowance against unresolved design risks. Design contingency often ranges from 5-10% of overall construction cost, but don’t treat that range as a substitute for assessing the project’s actual design maturity.

    For design contingency management, the suggested allocation is approximately 20% during design, 30% during design development and 50% or less during the construction-document phase. Use these stages to plan approval and spending, then review each allocation as information develops.

  3. Separate risk by responsibility. Distinguish design risks from construction risks and employer risks, such as changes or decisions retained by the employer. Each project should include an owner’s, contractor’s and designer’s contingency. Assign each identified risk to the relevant party and budget, so one reserve doesn’t silently absorb another party’s exposure. This separation also makes changes in responsibility visible as the project develops.
  4. Coordinate engineers, cost consultants and contractors. Early collaboration can surface construction risks sooner, allowing the team to address design coordination, site constraints and buildability before work begins. Record the expected cost and consequence of each issue, then update the estimate when it’s resolved. For a design-bid-build project, use developed drawings and tender information to refine the cost plan before setting the construction-stage reserve.
  5. Reassess the reserve against evidence, not elapsed time. Review the risk register after surveys, design approvals and significant design changes. Mark risks as reduced, passed or still active, and link each adjustment to supporting information. Completed drawings and tendering can improve cost certainty, but unresolved interfaces or employer decisions may still require a reserve. Release unused contingency only when its associated risk no longer applies.

How to Set a Construction Project Contingency Budget

How Much Contingency Should You Allow?

During delivery, assess the reserve against current risks and forecast project cost, not just the original percentage. Use each review to prepare a clear balance of approved spending, pending changes and remaining exposure.

  1. Set a regular review point. At each cost review, compare the latest forecast with the remaining contingency and active risk register. Record approved drawdowns, pending requests and committed exposure separately. This shows whether the reserve still matches the risks ahead, rather than simply tracking how much time has passed. A frozen design during construction may have a typical contingency of 3-5%, but unresolved risks still matter.
  2. Reassess as the project matures. Update the estimate when design information, procurement outcomes or site findings change the expected cost. A well-managed project typically maintains contingency between 3% and 15% of its estimate to complete. Treat this as a review range, not an automatic target. If the remaining reserve falls outside it, examine the causes before deciding whether to retain, increase or release funds.
  3. Test the balance against remaining risk. Compare contingency with current risk exposure, then examine the risks behind the calculation. A contingency-to-risk-exposure ratio from 0.75 to 1.25 is generally considered reasonable. A ratio below that range may signal insufficient cover; a higher ratio may reflect significant uncertainty or excess reserve. The ratio alone cannot explain the position, so document the major risks and their likely cost effects.
  4. Assess every change order before approval. Identify whether the request responds to an unforeseen event, corrects an estimate issue or adds scope. Contingency may cover an eligible risk event, but it shouldn’t fund a late upgrade or added feature. Record the reason, cost forecast, approval and effect on the remaining reserve. This makes each drawdown traceable and helps prevent the same change from appearing in both the base estimate and contingency.
  5. Release funds only when risks have passed. Review each open risk at project milestones and record evidence that its likelihood or impact has reduced. Keep funds for active risks, including unresolved interfaces or approvals, even when earlier project stages are complete. Once a risk is no longer relevant, release its associated allowance through the agreed approval process. This keeps unused funds visible and preserves a credible final project cost forecast.

Integrating contingency with project controls

Connect contingency to the cost forecast, risk register and programme to keep its purpose visible. Project management controls turn uncertainty into a current figure that stakeholders can review and act on.

  1. Set a controlled baseline. Record the approved base estimate, contingency allowance and programme assumptions separately. The baseline gives the project team a reference for identifying cost movement without disguising it as contingency spending. Link each risk to its potential cost and schedule effect. For a complex build, this makes the reserve easier to explain than a single, untracked percentage.
  2. Use a consistent contingency report. At each cost review, show approved drawdowns, pending drawdowns, released contingency, committed exposure and the remaining allowance. Include the latest forecast and explain changes since the previous report. Stakeholders can then distinguish funds already spent from requests awaiting approval and risks that may still affect project costs.
  3. Connect cost and programme controls. Identify schedule risks that could extend commitments, increase indirect costs or reduce productivity. Where a specific completion date matters, include programme contingency and report it alongside cost contingency. A delay risk should appear in both the risk register and programme forecast, with its expected cost effect visible in the cost report.
  4. Set a clear drawdown process. Define who can approve contingency use, what evidence each request needs and how the decision enters the forecast. Link each request to a risk event, change order or forecast impact. Record the reason, approval status and remaining balance. This control prevents contingency from becoming an informal source of funding for unrelated scope changes.
  5. Use reviews to update decisions. Compare current exposure with the remaining allowance and test whether assumptions still hold. If a risk has passed, document the evidence and release its associated funds. If a new risk emerges, assess its probability, cost impact and programme effect before changing the forecast. Report the revised figure and rationale to stakeholders.

Clear cost and programme reporting helps keep construction decisions grounded in current information. Discuss your construction project and the practical considerations behind its delivery.

Willmac Group: Extensions

Willmac Group delivers extensions, new builds and construction, including brickwork, through a comprehensive, integrated, one-roof service. If you’re moving from budget planning towards a defined building project in Chester, the North West or North Wales, consider how the proposed scope, site conditions and design decisions shape the work and its risks. Clear cost planning helps separate agreed requirements from contingency reserved for uncertainty, making it easier to discuss priorities before construction begins.

For an extension or new build, Willmac Group can help deliver the construction work as the project moves from plans into building. A useful next step is to outline the intended scope and the key decisions already made, so the conversation can focus on the work involved and how it will be managed.

To discuss your project, contact Willmac Group.

Put your project plans into motion

A well-managed construction project contingency budget is more than a reserve on a spreadsheet. It gives you a clearer basis for decisions as the scope, evidence and delivery plan develop. Before moving forward, bring together the current estimate, key assumptions and unresolved decisions. This creates a practical starting point for discussing priorities and the work needed to turn your plans into a build.

Willmac Group undertakes extensions, new builds and construction, giving you a route from project plans to building work. Share the outline of your project and the decisions you’ve already made to begin a focused conversation about its next stage.

Contact Willmac Group to discuss your project and take the next step with a clearer plan.

Frequently Asked Questions

What is a contingency budget?

A contingency budget is a reserved part of a project’s funding for costs that cannot be fully predicted at the outset. It sits alongside the base estimate rather than replacing it. For example, a project team can record a potential site issue as a risk, then draw on the reserve if it occurs. Planned purchases with prices still being finalised belong in separate allowances.

What Is a Contingency in Construction?

In construction, contingency is a controlled reserve for eligible costs arising from uncertainty during delivery. It can help address an unexpected condition that affects the work, such as a concealed structural issue discovered during refurbishment. It isn’t a general fund for upgrades or additions requested after work starts. Recording the cause and approval for each use helps distinguish genuine risk events from changes to the agreed scope.

How do contract types affect contingency management?

Contract terms determine who controls contingency and what happens to unused funds. Under a lump-sum contract, the contractor usually retains unused contingency; under a GMP contract, it’s typically shared between the owner and contractor. Before work begins, identify the relevant clauses covering control, permitted use and final reconciliation. This helps all parties understand how contingency decisions affect their responsibilities and the project’s financial closeout.

How much should I actually carry?

Start with a percentage that reflects the project’s estimate maturity and risk, then test it against identified exposures. For early screening or concept development, 5-15% can be a rule of thumb. A lower-risk project may sit nearer the lower end; incomplete scope or difficult site conditions support a higher allowance. Apply the percentage to the base estimate, and keep planned variable-cost items separate.

What is the proper process for accessing contingency funds?

Use a documented approval process before committing reserve funds. The request should identify the risk event or change order, explain why contingency is appropriate, and set out the forecast cost and effect on the remaining balance. The authorised decision-maker can then approve or reject it against the agreed rules. Record the decision and update the cost forecast so stakeholders can trace its use from request to reported expenditure.

When should I reduce or release unused contingency?

Reduce or release funds when the related risk has been resolved, ruled out or become irrelevant to the remaining work. For example, once an investigation removes a specific ground-condition uncertainty, review the associated reserve against the findings. Don’t release funds just because construction has progressed or time has passed. At closeout, reconcile approved expenditure, outstanding commitments and active risks before releasing any remaining balance.

What is a construction project contingency budget?

A construction project contingency budget is the project’s planned reserve for cost effects that are uncertain when the estimate is prepared. It gives the owner a way to address eligible risks without confusing them with the agreed base scope. For instance, a risk register can connect a possible event to a potential cost and a decision process. Keep the reserve visible in forecasts, rather than letting it disappear into general project spending.

How much contingency should a UK construction project budget include?

For a UK new build with a settled design, a typical construction contingency is 5-10% of construction cost. A refurbishment or conversion commonly uses 10-15%, while an older building with structural uncertainty may need up to 25%. Treat these as project-type guides, then adjust for design maturity, site knowledge and remaining risks. A public business case has a separate optimism-bias assessment, not simply a construction reserve.
